May 15 Update
May 18th, 2026
The exterior continues to progress, but there's so much happening inside as well! Updates from our team include:
- The metal roofing and solatube skylight install for covered classroom is complete.
- Siding progressing around the site: install, painting.
- Conduit routing and insulation install for the mechanical room was completed.

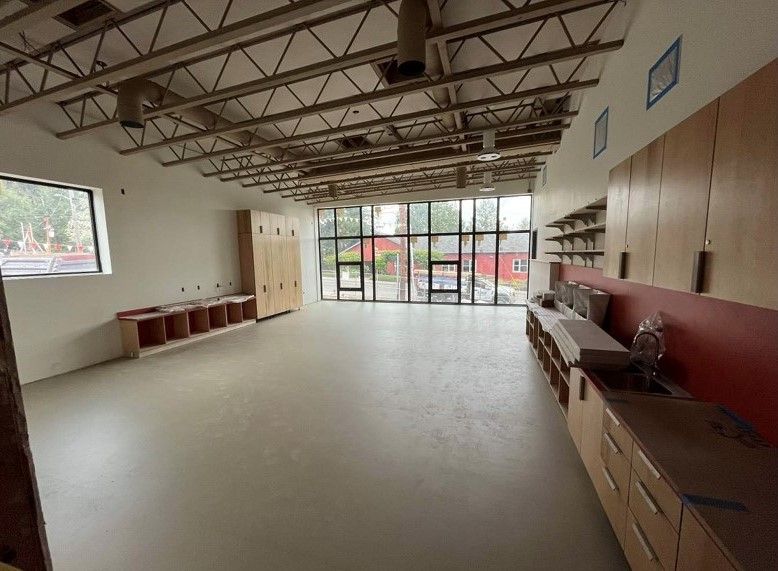

- Interior work includes flooring/carpeting, ceiling trim, wall paneling, and light fixture installs.
- Precast tread and landing install at the exterior steel stair started this week.
- The water room buildout started this week.
- Grading at the NW site is ongoing.
- All electrical utility trenches were backfilled this week.
